Integrating Advanced Welding Automation

Introduction

Manufacturers can't hire their way out of a welding capacity problem anymore. The American Welding Society projects 320,500 new welding professionals will be needed in the U.S. by 2029, with roughly 80,000 positions to fill annually through the rest of the decade (AWS Workforce Data, 2025). There simply aren't enough qualified welders entering the trade to close that gap.

This shortage collides with three pressing operational realities:

  • Inconsistent weld quality that drives rework and scrap costs
  • Safety exposure in hazardous welding environments, including fume inhalation and burn risks
  • Growing pressure for throughput beyond a single shift that manual labor alone can't sustain

This guide breaks down what advanced welding automation actually means, the technologies making it possible, and a step-by-step framework for integrating it into an existing production line without blowing up your schedule or budget.

Key Takeaways

  • Match automation level to the job—from mechanized assistance up to fully autonomous robotic welding cells
  • AI-assisted simulation compresses robot programming from weeks to days
  • Integration success hinges on workforce readiness, not hardware alone
  • A phased rollout cuts downtime risk and shortens time-to-ROI
  • Vision systems and predictive maintenance are now baseline expectations in modern welding cells

What Is Advanced Welding Automation?

Advanced welding automation combines robotics, sensors, and intelligent software to control the entire weld process with minimal human intervention. It goes well beyond a machine simply holding a torch steady. Modern systems track seam position, adjust for part variation in real time, and inspect their own work before a part moves to the next station.

There's no single technology that defines "advanced" welding automation. It's a spectrum of capability, and the right point on that spectrum depends on your production volume, part complexity, and quality requirements.

The Automation Spectrum: From Assisted to Robotic

Understanding where your operation sits on this spectrum is the first real decision point:

  • Mechanized welding: The machine holds the torch, but an operator manually adjusts positioning based on what they see.
  • Semi-automatic welding: Equipment controls wire feed and welding conditions, while the operator still guides the gun by hand.
  • Automatic welding: Equipment runs pre-set parameters with occasional or no operator observation required.
  • Robotic welding: A programmed robotic arm executes the entire weld cycle independently, from positioning through torch travel.

Within robotic welding, one more split matters for most plants. Industrial robotic welders are caged, high-precision machines built for high-volume production. Collaborative robots (cobots) are lower-volume, flexible units designed to work near people without the same guarding requirements.

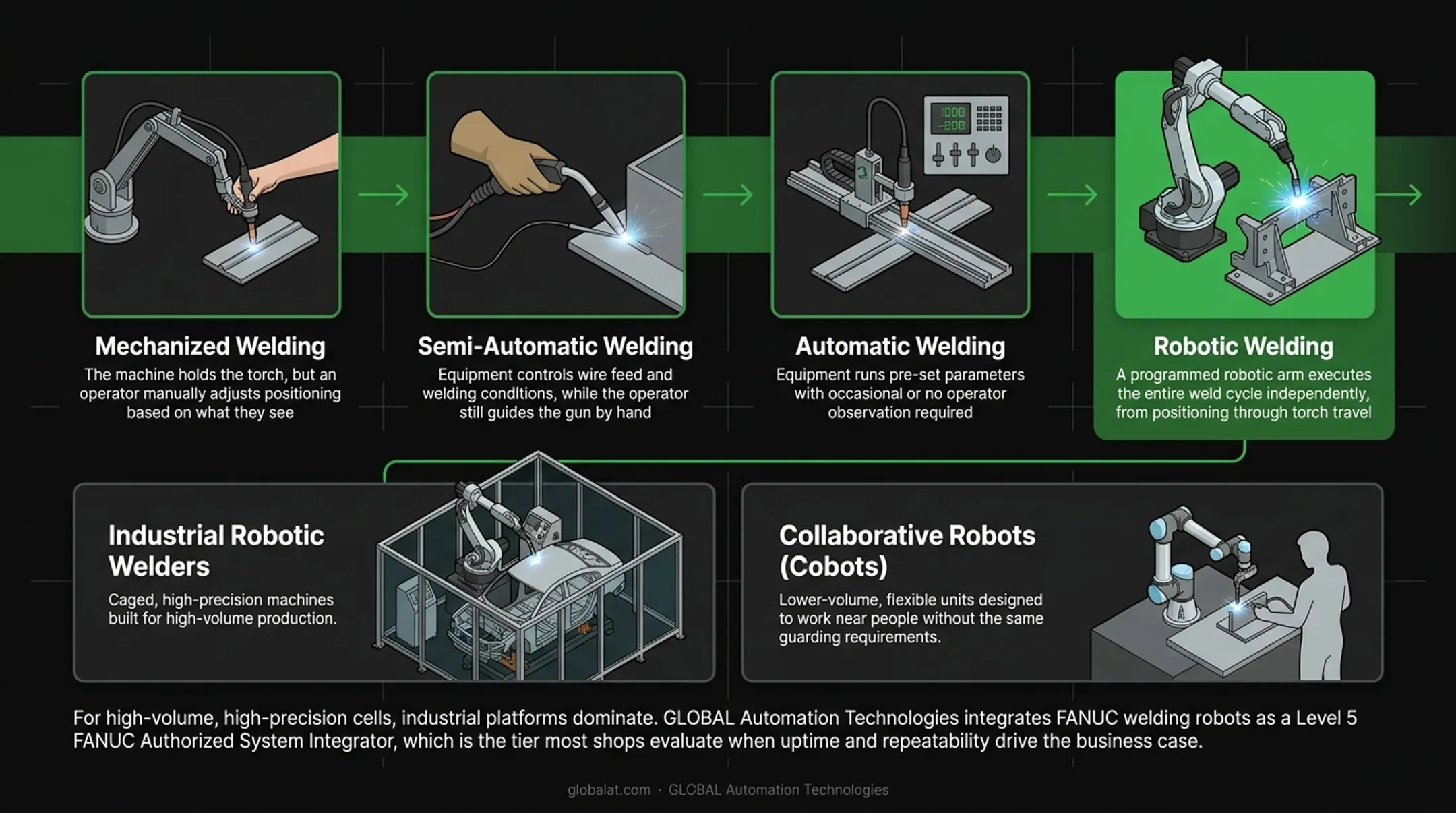

Welding automation spectrum from mechanized to robotic cobot systems

For high-volume, high-precision cells, industrial platforms dominate. GLOBAL Automation Technologies integrates FANUC welding robots as a Level 5 FANUC Authorized System Integrator, which is the tier most shops evaluate when uptime and repeatability drive the business case.

Core Technologies Powering Modern Welding Automation Integration

Five technologies separate a genuinely advanced welding cell from a robot simply swinging a torch through pre-taught points.

AI-assisted simulation and offline programming let engineers validate an entire weld path virtually before anyone touches the production floor. ABB's RobotStudio deployment at OMAS delivered a 50% productivity increase using offline programming and simulation (ABB, 2024).

This mirrors what GLOBAL's engineers see in their own practice, where AI-assisted simulation has compressed robot programming from weeks to days.

Real-time seam tracking and adaptive control correct the torch path automatically when part fit-up varies. FANUC's through-arc tracking, for example, adjusts vertical and lateral trajectory when parts arrive warped or misplaced.

Vision-based bead quality inspection catches defects before parts move downstream. This includes:

  • Missed paths where material wasn't deposited correctly
  • Thin or inconsistent bead coverage
  • Off-spec placement relative to the programmed path
  • Gaps that would leave a joint structurally compromised

Predictive maintenance and health assessments flag robotic equipment issues before they cause unplanned downtime. AI-driven health assessments surface wear patterns and component risk early, so teams schedule maintenance before a cell goes down mid-shift.

Industry 4.0 connectivity ties welding cells into plant-wide monitoring systems. Real-time production data feeds SCADA and IoT platforms so quality and throughput issues surface immediately, not after a shift ends.

A Step-by-Step Framework for Integrating Welding Automation

Automation isn't a plug-and-play purchase. Skipping steps here is how projects blow past budget and timeline. A structured process protects both.

Step 1: Process Assessment and Feasibility Study

Before any equipment gets specified, integrators evaluate:

  • Part volume
  • Weld complexity
  • Material type
  • Existing line layout

This assessment determines whether automation is the right fit and sets a realistic ROI timeline before capital gets committed.

Step 2: System Design and AI-Assisted Simulation

Digital simulation validates cell layout, robot reach, and cycle time before a single dollar goes toward hardware. This is where AI-assisted programming earns its value. Engineers can model multi-robot coordination, test weld sequencing, and confirm cycle time targets entirely in a virtual environment.

Step 3: Robot, Tooling, and End-Effector Selection

Robot payload, reach, and welding process (MIG, TIG, or resistance) determine which robot and tooling combination actually fits the application. Engineers design fixture layout, servo positioning, and part presentation around the specific geometry of the parts being welded. There's no universal setup that works across every product line.

Step 4: Installation, Commissioning, and Validation

This is the turnkey execution phase: build, on-site installation, and commissioning. GLOBAL's approach covers this full lifecycle, from layout through validation and operator training, under a single contract. The goal is a system that's already proven in simulation before it ever runs its first production part.

Step 5: Workforce Training and Ongoing Technical Support

Long-term success depends on trained operators and available engineering support just as much as it depends on the hardware. This is where GLOBAL's combined model matters: its automation systems and engineering services teams design and build the welding cell, while its technical staffing can place controls engineers, robot programmers, or maintenance technicians on-site to keep it running. Because the work sits under one roof, the people who build the cell already know what skills keep it productive on the floor.

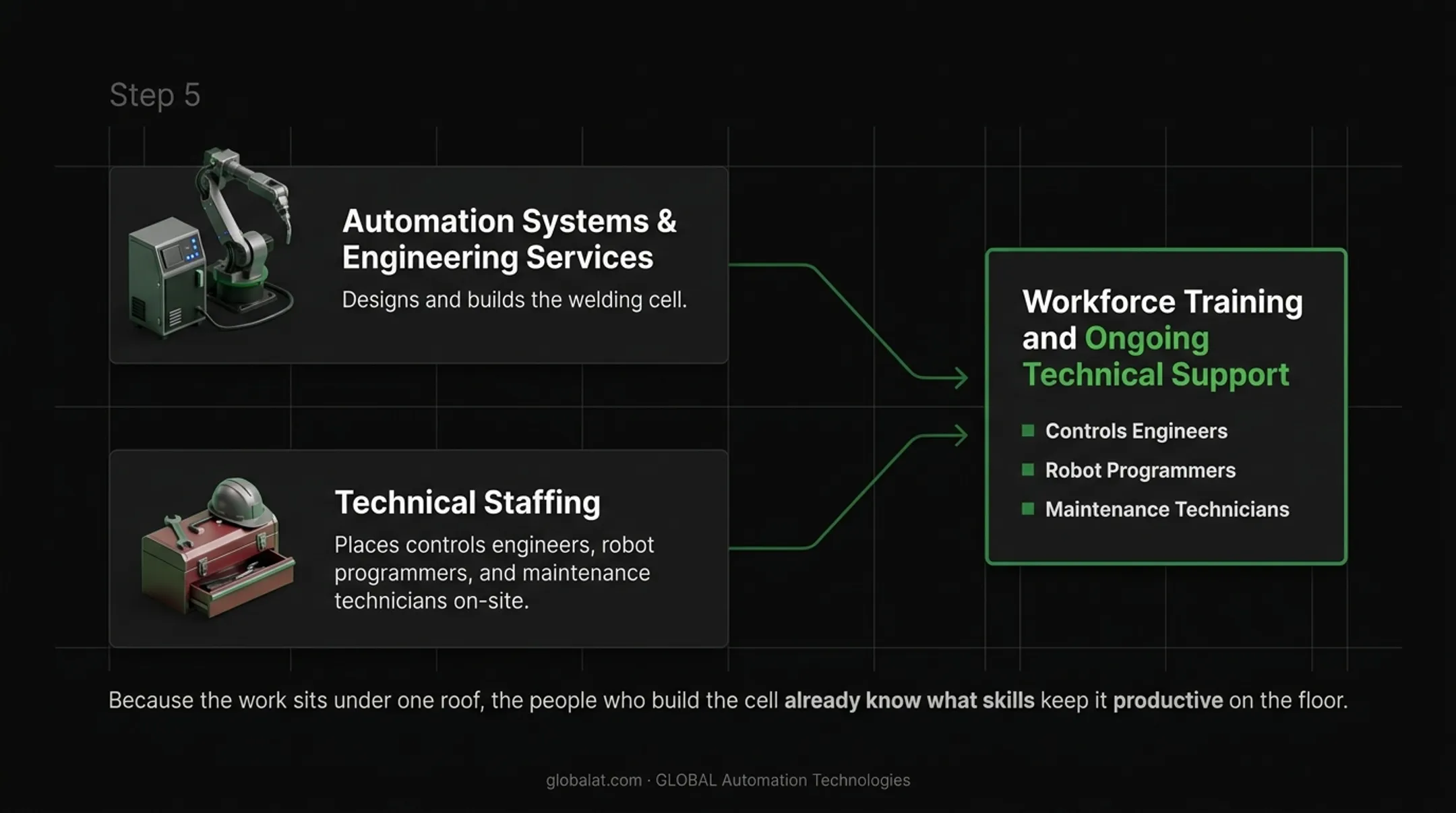

5-step framework for welding automation integration process flow

Common Integration Challenges and How to Solve Them

Even well-planned welding automation projects hit the same few obstacles. Three come up most often, and each has a practical fix if you address it early.

High upfront investment. Cost concerns are real, but framing matters. ESAB modeling shows a cobot welding system under $170,000 can reach payback in under 24 months (ESAB, 2023).

That figure is not universal. Cell complexity, volume, and tooling swing the range significantly. Still, it reframes automation as a mid-term investment rather than a sunk cost.

Skilled labor gaps in programming and maintenance. With an estimated 80,000 welding jobs to fill annually through 2029, finding in-house talent to program and maintain robotic systems is its own hurdle. Contract or contract-to-hire technical staffing bridges the gap so manufacturers can scale engineering support as production demands shift.

Integration complexity with legacy lines. Retrofitting automation into an existing line introduces layout constraints, timing conflicts, and material handling issues greenfield builds never face. A feasibility assessment before equipment purchase (facility constraints and current workflow) keeps a planned upgrade from turning into extended downtime.

Choosing the Right Welding Automation Integration Partner

Not every integrator offers the same scope. Look for these capabilities under a single contract:

  • Layout, design, and build of the full welding cell
  • Robot programming and simulation before metal is cut
  • Process validation prior to production launch
  • Installation and on-site commissioning
  • Operator training and technical documentation
  • Ongoing support after the line goes live

A partner that combines systems integration with technical staffing offers a real advantage. Instead of juggling separate vendors for the equipment and the people who run it, one relationship covers both. GLOBAL's model reflects this directly: the same organization that engineers a welding cell can also place the controls engineer who keeps it running two years later.

Cross-industry experience belongs on the same checklist. A welding fix proven in automotive production can often transform an aerospace or heavy equipment line. GLOBAL works through an "applications lens" rather than an industry lens, so methods proven in one sector transfer cleanly to another.

Frequently Asked Questions

What is welding automation?

Welding automation uses robotics, sensors, and software to perform welding tasks with minimal manual intervention. It ranges from mechanized torch assistance to fully autonomous robotic welding cells.

What is the newest technology in welding?

Top developments right now include AI-assisted simulation and offline programming, real-time vision-based bead inspection, and predictive maintenance systems that flag equipment issues before failure.

How much does it cost to integrate a robotic welding system?

Cost varies significantly based on cell complexity, production volume, and tooling requirements. Cobot systems under $170,000 often reach payback within 24 months, though every project differs.

How long does a welding automation integration project typically take?

Timelines depend on feasibility study, simulation, and commissioning scope. Simple cells may take a few months; complex multi-robot lines can take closer to a year.

Can welding automation work for low-volume or custom production runs?

Yes. Flexible automation and cobots handle high-mix, lower-volume welding well, unlike fixed automation systems built around a single repeated part.

Do manufacturers need to hire new staff to run automated welding systems?

Existing teams can often be trained on new systems. Many manufacturers also use contract or contract-to-hire technical staffing to fill programming and maintenance skill gaps without a full-time hire.
