This guide breaks down what turnkey machines and custom equipment actually mean, when each makes sense, and how to vet a partner before signing a contract. We'll draw on GLOBAL Automation Technologies' perspective as both a systems integrator and technical staffing provider, a dual role that shapes how we think about accountability and long-term support.
Key Takeaways
- Turnkey systems arrive fully designed, built, tested, and installed, ready to run with minimal customer input
- Custom equipment is engineered piece-by-piece when your process falls outside standard configurations
- Pick based on production goals, in-house engineering capacity, and how fast you need to go live
- Single-source integrators cut project risk and end the finger-pointing common in multi-vendor builds
What Is a Turnkey System?
The term "turnkey" comes from construction contracting, where a builder hands over a finished project ready for the owner to simply "turn the key" and start using it. Applied to manufacturing, a turnkey machine arrives fully functional, tested, and integrated. No additional engineering is required from the customer.
Merriam-Webster defines turnkey as built, supplied, or installed complete and ready to operate. That's the standard worth holding partners to.
Core Turnkey Deliverables
A real turnkey project covers:
- Project management and process assessment
- Engineering, design, and layout
- Robot simulation and offline validation
- Controls engineering, machine vision, and SCADA/IoT connectivity
- Build, installation, and commissioning
- Operator training and technical documentation
- Ongoing support and health monitoring
GLOBAL, a top-tier Level 5 FANUC Authorized System Integrator, builds every engagement around this full sequence so the customer receives a production-ready cell, trained operators, and the documentation to keep it running.
Turnkey vs. "Custom-Built"
Here's where confusion creeps in: a machine can be both custom-engineered and delivered turnkey. Turnkey describes who owns integration and what condition it's delivered in. Custom describes how application-specific the engineering is. These are two different questions, not opposite ends of one spectrum.

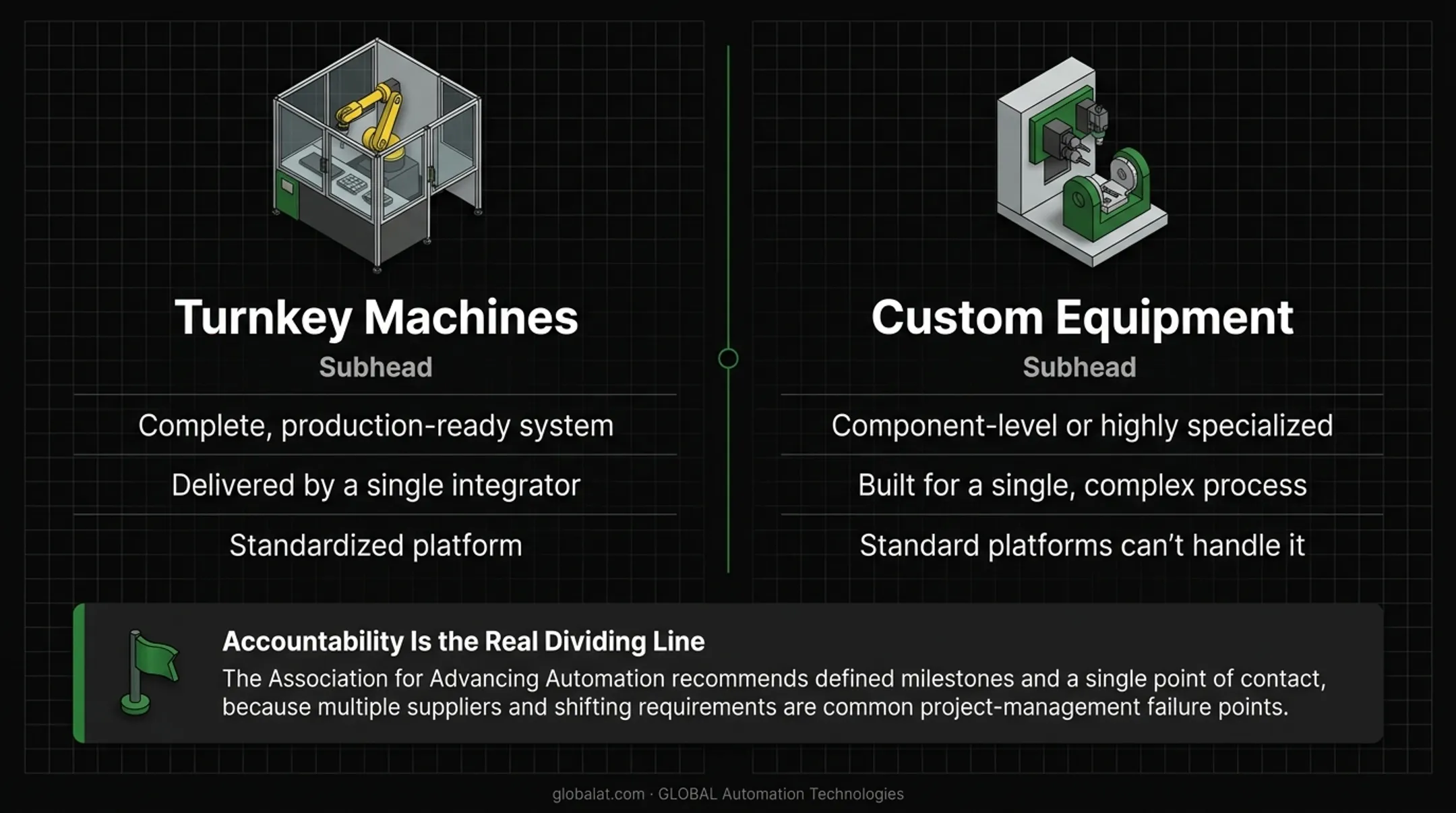

Turnkey Machines vs. Custom Equipment: Key Differences
Turnkey machines arrive as complete, production-ready systems from a single integrator. Custom equipment is component-level or highly specialized: built for a single, often complex, non-standard process that a standard platform can't handle.
| Factor | Turnkey | Custom |
|---|---|---|
| Accountability | One point of contact, one warranty | Multiple vendors, potential finger-pointing |
| Speed to production | Faster, built on proven platforms | Slower, requires scoping and iteration |
| Flexibility | Bounded by standard architecture | Mix technologies, upgrade incrementally |
| Best fit | Common processes, tight timelines | Unique geometry, niche or evolving needs |

Accountability is the real dividing line. The Association for Advancing Automation recommends defined milestones and a single point of contact specifically because multiple suppliers and shifting requirements are common project-management failure points.
The Hybrid Reality
Most real-world projects aren't purely one or the other. A turnkey cell often gets built around custom-engineered components: a specialized gripper, a unique fixture, or a part-specific end-of-arm tool.
GLOBAL's machine tending systems, for instance, use standard turnkey delivery while engineering custom gripper design and fixture integration for each part geometry and cycle-time requirement.
Why Manufacturers Choose Turnkey Solutions
Three forces are pushing manufacturers toward turnkey: speed, risk reduction, and a shrinking talent pool.
Faster time-to-production. Pre-engineered platforms cut the scoping and iteration cycles that stretch custom builds. Single-source delivery means your team isn't managing five vendor handoffs.
AI-assisted simulation compresses those timelines further. GLOBAL's engineers model, test, and optimize robot programs before code runs on the floor, turning programming windows that once took weeks into days with fewer commissioning surprises.
Reduced risk. One contract, one warranty, one party accountable from design through startup.
The Labor Math Behind the Trend

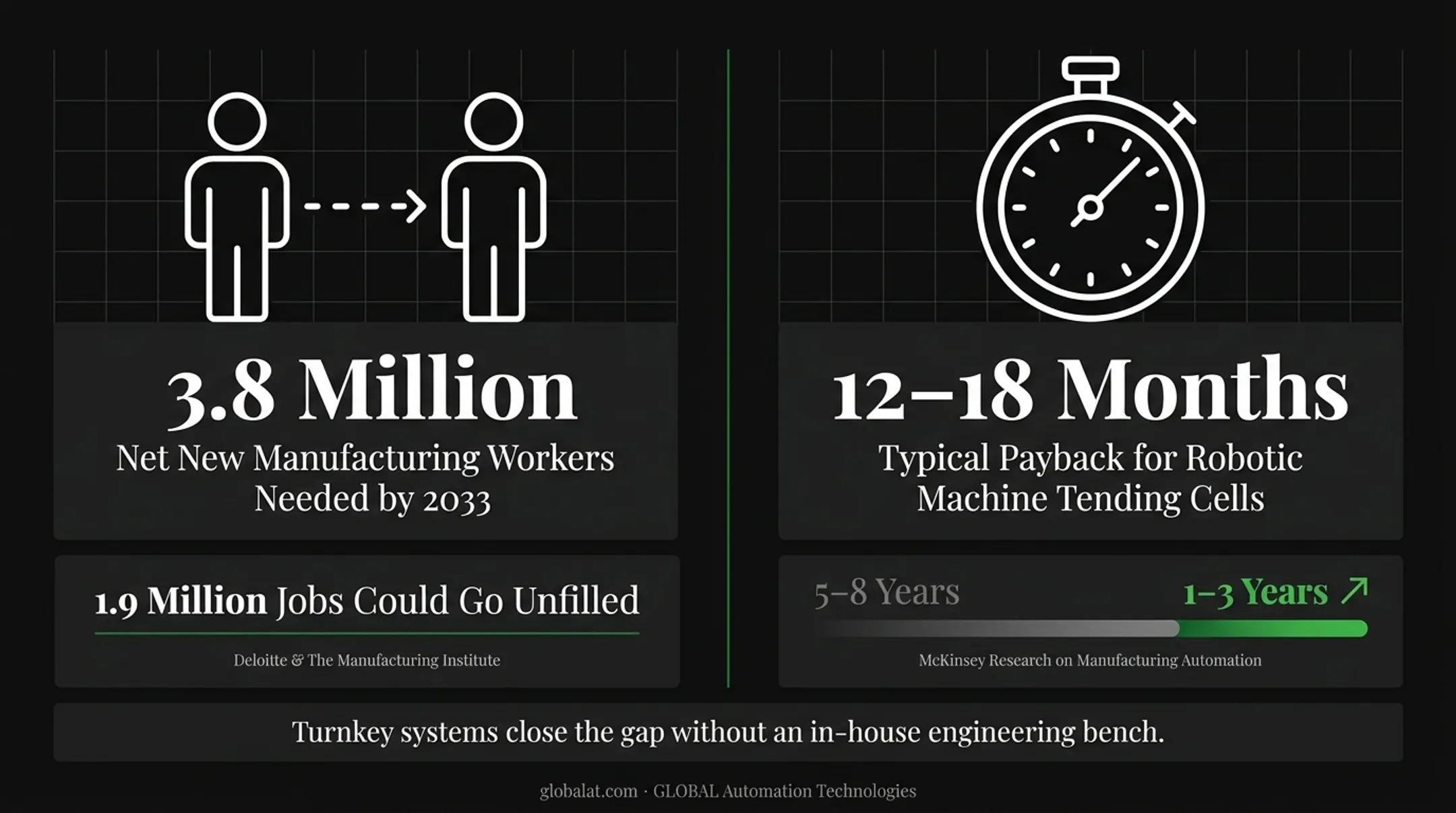

The skills gap is real and measurable. Deloitte and The Manufacturing Institute project U.S. manufacturing could need 3.8 million net new workers between 2024 and 2033, with as many as 1.9 million jobs going unfilled if applicant and skills gaps persist.
That's a direct reason turnkey systems appeal to plants without deep in-house engineering benches. You're not staffing a project team to design controls architecture from scratch.
Payback strengthens the same case. Robotic machine tending cells are commonly cited as paying for themselves in 12-18 months, driven by higher spindle utilization and extended unattended operation through breaks and shift changes.
McKinsey's broader research on manufacturing automation found current payback periods of one to three years, down from the five-to-eight-year timelines seen historically. Treat any payback estimate as a starting point, not a guarantee. Your actual numbers depend on shift structure, labor rates, and utilization gains specific to your line.

What's Included in a Turnkey Machine Project

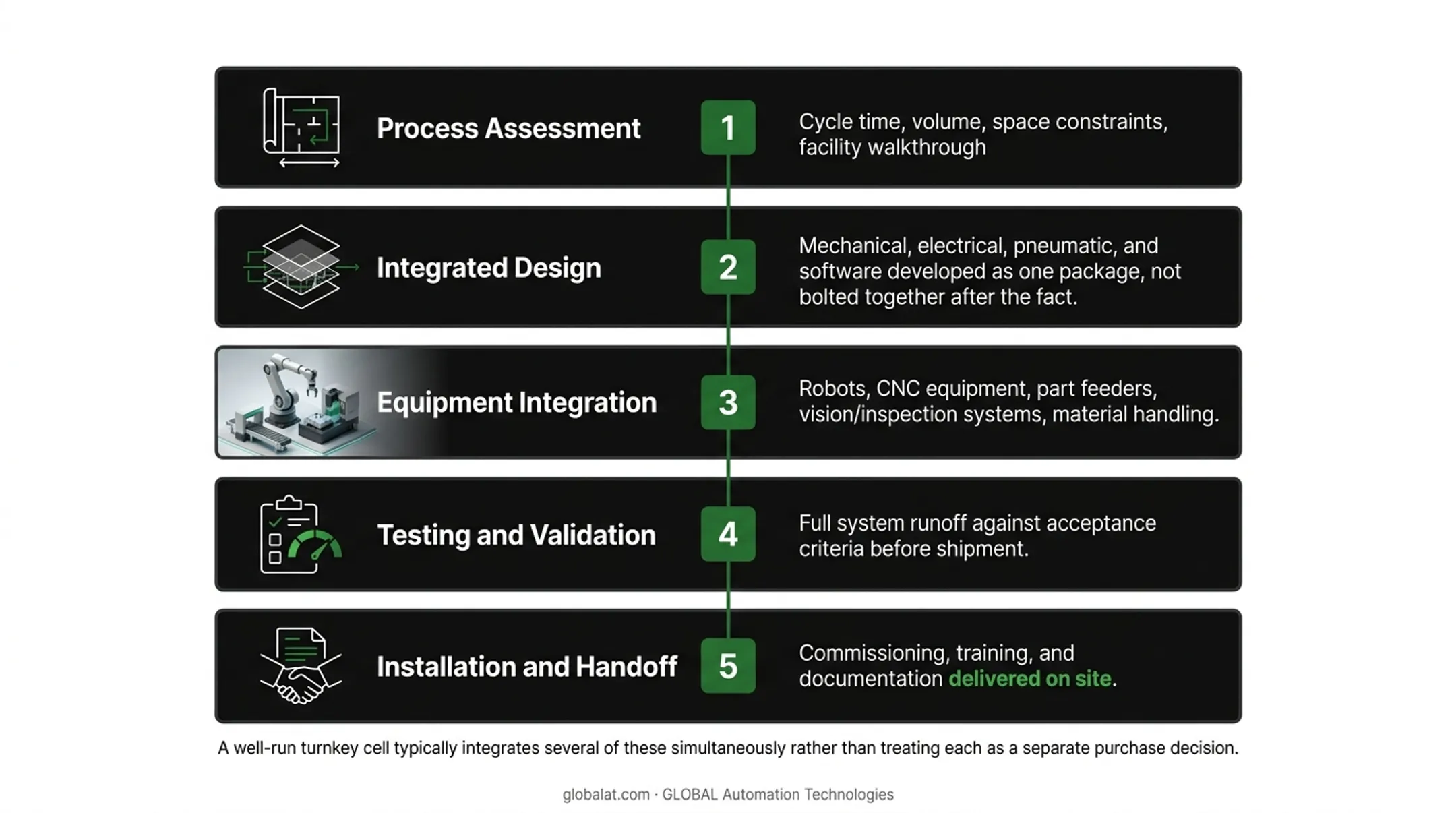

A properly scoped turnkey project moves through distinct phases:
- Process assessment — cycle time, volume, space constraints, facility walkthrough
- Integrated design — mechanical, electrical, pneumatic, and software developed as one package, not bolted together after the fact
- Equipment integration — robots, CNC equipment, part feeders, vision/inspection systems, material handling
- Testing and validation — full system runoff against acceptance criteria before shipment
- Installation and handoff — commissioning, training, and documentation delivered on site

The equipment mix varies by application, but a well-run turnkey cell typically integrates several of these simultaneously rather than treating each as a separate purchase decision.
Applications Across Industries

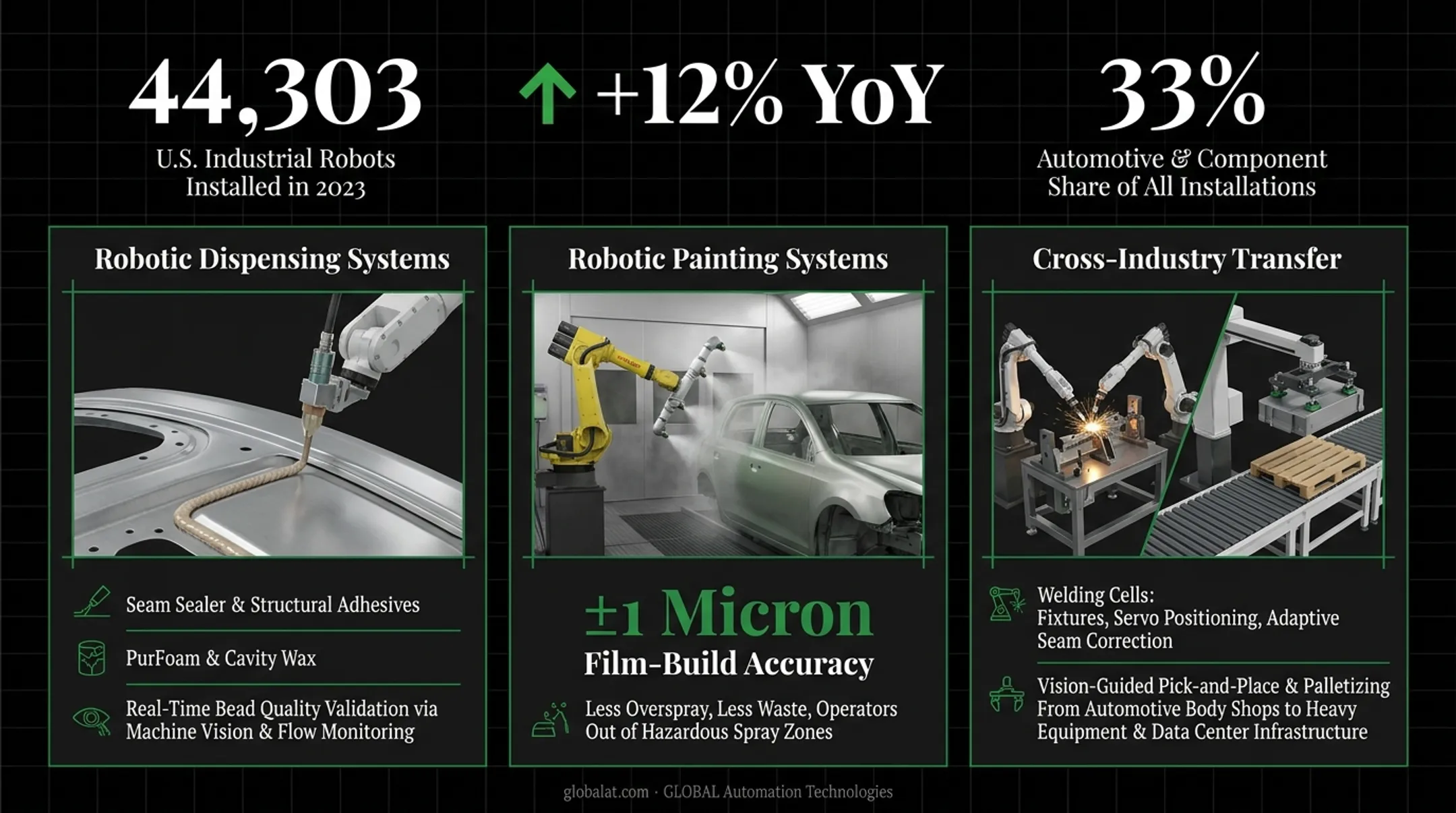

Automotive and EV manufacturing remains the heaviest adopter. U.S. factories installed 44,303 industrial robots in 2023, up 12% year-over-year, with automotive and component manufacturers representing 33% of all installations. Growth is driven largely by the EV transition and ongoing labor shortages.
Tier 1 suppliers face some of the tightest tolerance requirements in manufacturing. Robotic dispensing systems handle:
- Seam sealer and structural adhesives
- PurFoam and cavity wax
- Real-time bead quality validation with machine vision and flow monitoring
That combination catches a misplaced or incomplete bead before the part moves downstream.
Robotic painting systems built on FANUC platforms hold film-build consistency to ±1 micron accuracy. The result is less overspray and material waste, and operators are pulled out of hazardous spray environments entirely.

Heavy equipment and data center infrastructure manufacturers are increasingly adapting these automotive-proven approaches. Robotic welding cells with fixtures, servo positioning, and adaptive seam correction (originally refined in automotive body shops) now show up on agricultural and industrial equipment lines. Material handling systems using vision-guided pick-and-place and palletizing follow the same pattern of cross-industry transfer.
How to Choose the Right Turnkey Partner
Not every integrator delivering a "turnkey" quote is actually taking single-source responsibility. Ask these questions before signing:
- Does the partner design, build, install, and support in-house, or are they brokering multiple vendors and passing along the coordination risk?
- What happens after installation? A one-time install with no ongoing engineering support leaves you exposed the moment something needs adjusting.
- Do they have cross-industry experience? Partners who've solved welding problems in automotive can often apply that logic to heavy equipment or aerospace faster than a specialist starting from zero.
GLOBAL's dual-division model addresses the second point directly. Beyond the initial build, the staffing division supplies controls engineers, robotics technicians, and commissioning engineers on contract, contract-to-hire, or direct-hire terms. The same call that gets you the system can also get you the people to run it long after commissioning wraps up.
After you've vetted support depth, use credentials as a secondary screen. Programs like the A3 Certified Robot Integrator program require an on-site audit and safety-practice review. Certification alone doesn't confirm application fit, so always request references that match your specific process and complexity.
Frequently Asked Questions
What does "turnkey system" mean?
A turnkey system is fully designed, built, tested, and delivered ready to operate with minimal customer input. The integrator owns the entire scope, from engineering through commissioning.
Why is it called turnkey?
The term traces to construction and real estate, where a contractor hands over a finished project ready for the owner to simply "turn the key" and use it. Manufacturing borrowed the analogy for complete, ready-to-run systems.
Is a turnkey machine more expensive than custom equipment?
Turnkey often carries a higher upfront cost but lower total risk and faster ROI. Custom builds can look cheaper initially but frequently rack up hidden costs in engineering, debugging, and delays.
How long does it take to install a turnkey production system?
Timelines vary heavily by complexity and application. Turnkey systems deploy faster than piecing together a multi-vendor custom build, since much of the engineering is already proven.
Can a turnkey machine be customized later?
Most modern turnkey platforms use modular architecture, allowing adaptation for new parts, volumes, or processes. Modularity has limits, though. Payload, reach, and safety envelopes still constrain what's possible.
What industries rely most on turnkey automation?
Automotive OEMs and Tier 1 suppliers lead adoption. Heavy equipment and data center infrastructure manufacturers follow, applying the same proven automation approaches to new production challenges.
