Introduction
Walk any plant floor today and you'll likely find a robot cell running welding cycles, a PLC controlling a conveyor, an MES tracking quality, and an ERP handling orders. Each system speaks its own language. Manufacturers are under growing pressure to unify these automation islands into one connected production system instead of managing them separately.
That pressure shows up in the data. A 2026 Rockwell Automation study of 1,560 manufacturers across 17 countries found that 59% are actively using smart-manufacturing technologies in operations. Yet only 43% of the data they collect gets used effectively. The gap isn't robots or software. It's integration.
Integrating manufacturing automation systems isn't as simple as bolting a robot onto a line and calling it done. Success depends on a few fundamentals:
- Architecture that connects machines, controls, and enterprise systems
- Data standardization so every system shares a common language
- Workforce readiness to run and sustain the integrated line
- The right sequence—full integration versus a phased approach
This guide covers the prerequisites, the exact steps, and how to decide which path fits your plant.
Key Takeaways
- Follow six sequential steps—audit, design, select, simulate, install, train—or risk the most common cause of failed projects.
- Legacy equipment compatibility, data standardization, and workforce readiness matter as much as the robots themselves.
- AI-assisted simulation cuts programming time and reduces costly on-site surprises.
- Phased pilots often de-risk larger investments better than jumping straight to full-scale integration.
How to Integrate Manufacturing Automation Systems: A Step-by-Step Framework

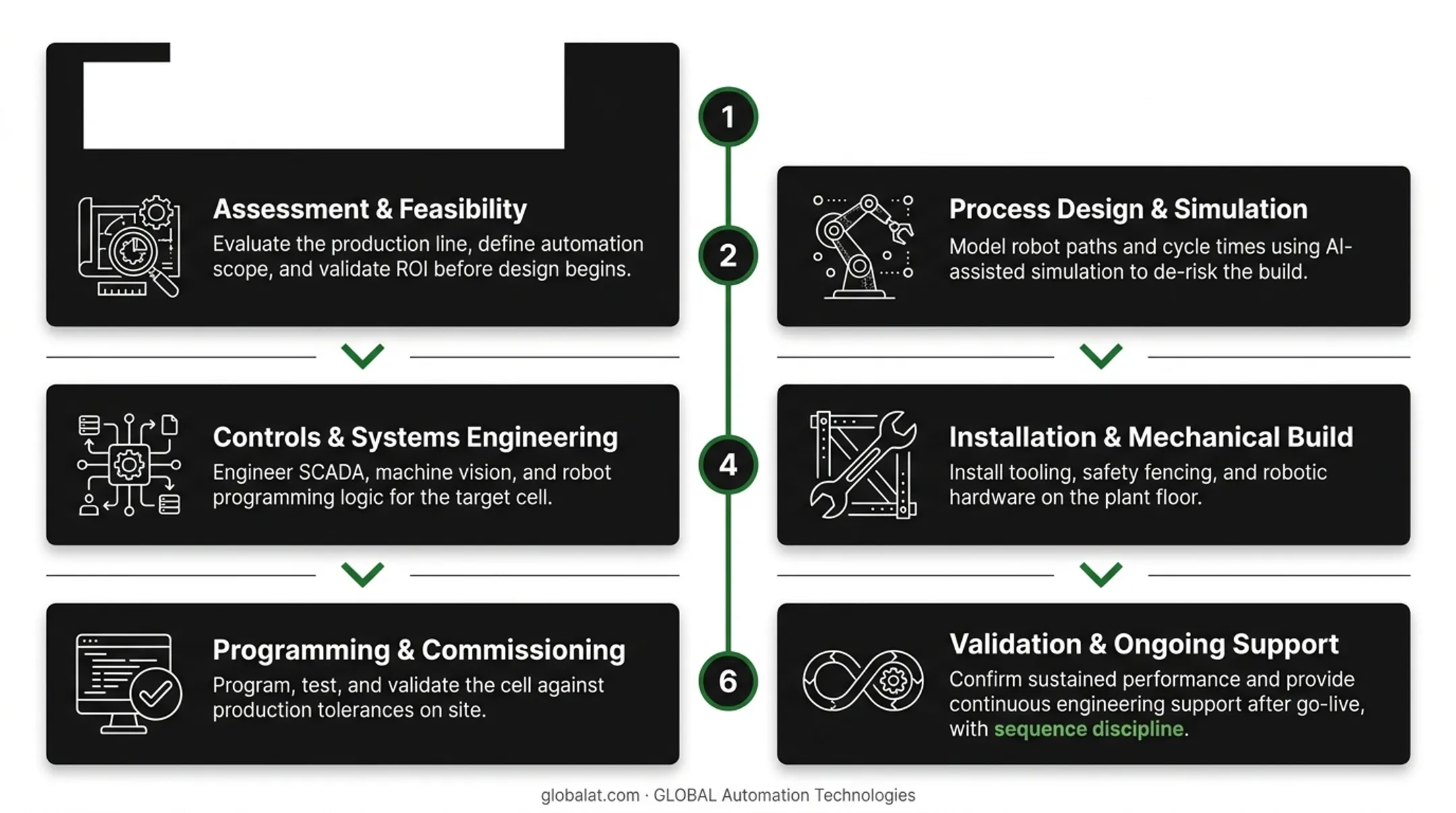

Integration succeeds or fails based on sequence. Follow these six steps in order, since skipping ahead is where most projects go wrong.

Step 1: Audit Current Systems and Define Integration Goals
Before selecting a single robot, map every system already running on your floor: PLCs, HMIs, SCADA, MES, and ERP. Don't forget the manual workarounds nobody talks about, like the spreadsheet a supervisor uses to track downtime because the MES doesn't capture it.
This audit pinpoints exactly where data and processes break down between layers.
Then set goals tied to measurable KPIs, not vague ambitions like "automate everything":
- Overall Equipment Effectiveness (OEE) - availability, performance, and quality combined
- Cycle time - how long each part actually takes to produce, start to finish
- First-pass yield - the percentage of units that pass quality checks without rework
Automate a process nobody fully understands, and you risk automating the exact point where it breaks.
Step 2: Design the Automation and Data Architecture
Once you know what you're working with, design how the layers will communicate. Three tiers typically need clear paths:
- Control layer - robots, PLCs, drives
- Supervisory layer - HMI and SCADA
- Enterprise layer - MES and ERP
The ISA-95 standard (IEC 62264) defines this hierarchy, with particular focus on the interface between manufacturing operations (Level 3) and business planning (Level 4).
Protocol choice affects how well these layers actually talk to each other:
| Protocol | Primary Strength |
|---|---|
| EtherNet/IP | Industrial Ethernet using standard TCP/IP with Common Industrial Protocol |
| PROFINET | Open Ethernet-based exchange between controllers and devices |
| OPC UA | Shop-floor to enterprise interoperability across vendors and platforms |
| MTConnect | Structured, contextualized manufacturing-equipment data |
Beyond protocols, map dependencies between upstream and downstream processes. Automate one station without understanding what feeds it, and you don't remove the bottleneck. You just move it down the line.
Step 3: Select Equipment, Robot Platform, and an Integration Partner
Equipment selection should follow application requirements, not a price tag.
Payload, reach, and precision vary widely by task:
- Arc welding - based on reach, payload, repeatability, and weld-specific performance
- Painting - compact six-axis robots with roughly a 5 kg payload and extended reach for consistent coating
- Dispensing and sealing - payload and reach first, then acceleration, path accuracy, and hose management
- Machine tending - platforms spanning roughly 3 to 1,300 kg payload and 726 to 3,904 mm reach, depending on the part and the machine
GLOBAL Automation Technologies, which holds Level 5 status in FANUC’s Authorized System Integrator program, works primarily on FANUC robot platforms across all four categories, matching payload and precision to each part geometry and production rate rather than defaulting to one robot for every job.
Equally important: vet your integration partner on true turnkey capability. That means layout, build, programming, validation, installation, and ongoing support handled by one accountable team, not five vendors passing blame when something doesn't work.
Step 4: Simulate, Program, and Validate Before Deployment
Nothing should touch the shop floor before it's been tested virtually. Offline programming and simulation let engineers test robot paths, cycle times, and collision risks in software first.
The payoff is measurable. ABB reports that RobotStudio's automatic path planning can cut robot-programming time by 80% compared to manual programming.
At GLOBAL, AI-assisted simulation compresses programming timelines from weeks to days. Engineers model, test, and optimize robot programs before a single line of code runs on the floor. That cuts commissioning surprises and speeds time-to-production.
This step catches problems that are cheap to fix on a screen and expensive to fix on a production line. A robot arm that clips a fixture. A cycle time that misses target by seconds. A path that looks fine on paper but stalls in practice.
Step 5: Install, Commission, and Connect to Existing Systems
With the design validated, install the equipment. Then connect controls to existing MES/ERP and network infrastructure, validating real-time data flow between every layer instead of assuming it works.
Before releasing any line back to production, run these checks:
- Machine guarding aligned to OSHA 1910.212, covering point-of-operation and pinch hazards
- E-stop and fault handling validated between robot and PLC systems
- Lockout/tagout procedures confirmed for servicing and maintenance access
- Formal risk assessments aligned to ANSI/A3 R15.06 and ISO 10218-2 robot safety standards
Skip any of these, and you're not just creating compliance risk. You're creating the kind of on-floor incident that shuts a line down far longer than the commissioning delay ever would.
Step 6: Train the Workforce and Establish Ongoing Support
A perfectly integrated system still fails if nobody on the floor can run it. Training needs to happen hands-on, on the actual installed equipment, so operators and maintenance techs can run and troubleshoot the system independently.
This matters more than most manufacturers assume. Deloitte and The Manufacturing Institute project up to 3.8 million manufacturing positions will need to be filled between 2024 and 2033, with roughly half potentially going unfilled.
If you don't have in-house automation staff to run the new system, that gap doesn't have to stall the project. GLOBAL pairs systems integration with technical staffing (contract, contract-to-hire, or direct placement), putting controls engineers, robot programmers, and commissioning specialists on your floor when you need them.
Ongoing support continues after go-live. AI-driven predictive maintenance health checks flag equipment issues before they cause downtime, not after.
When to Integrate Now vs. Consider Alternatives
Full-scale integration isn't right for every plant, every time. It makes sense when multiple disconnected systems are already creating measurable production losses, compliance risk, or scaling constraints you can't engineer around with a single cell.
Signs You're Ready for Full Integration
Full integration tends to pay off when you have:
- High-volume, repetitive production with clear, identifiable bottlenecks
- Hazardous or quality-critical processes where consistency isn't optional
- Capital available for an 18 to 36-month payback window
- Multiple systems already competing for the same floor space and data
The longer payback window reflects the added scope: network upgrades, MES/ERP connectivity, and cross-department coordination that a single cell doesn't require.
When a Phased or Single-Cell Approach Fits Better
A phased approach usually wins when:
- Production involves small batches or highly variable part mixes
- Budget or floor space is limited
- This is your first automation project and you need proof before scaling further
Machine tending cells are a common starting point for exactly this reason. They typically pay for themselves in 12 to 18 months, driven by higher spindle utilization and fewer direct labor hours per shift. That makes a single cell a low-risk way to prove the model before committing to full-line integration.
What You Need Before Integration & Key Success Factors
Preparation determines whether integration delivers results or just creates a bigger, more expensive silo. Four variables matter as much as the hardware itself.
Equipment and Network Readiness
Confirm your PLCs, drives, and robots actually support modern communication protocols before committing to a design. Legacy equipment often needs middleware or protocol converters to bridge older systems. Identify these gaps during the audit, not after installation, when a fix costs far more.
Data Standardization
Integration only works if data formats match across control, MES, and ERP layers. Without standardization, you're not connecting systems. You're relocating the same disconnects onto a newer, more expensive network.
Workforce and Change Readiness
Bring floor operators and supervisors into design decisions early. Their input on real-world process quirks, like the fixture that always needs a manual nudge, reduces resistance later. Those same people become internal champions who help the system succeed once it's live.
Cybersecurity and Vendor Strategy

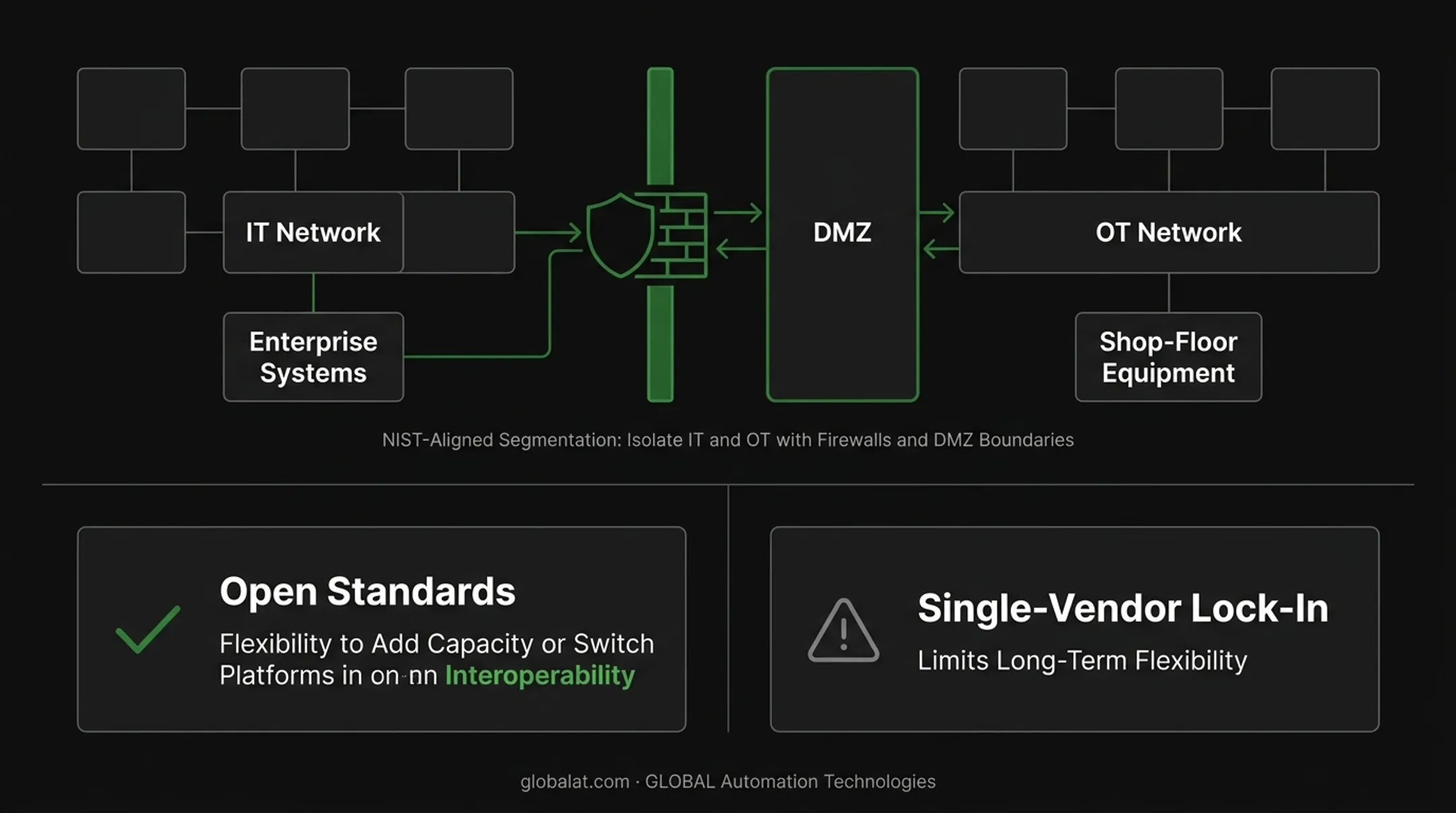

NIST guidance recommends segmenting IT and OT networks and isolating them with firewalls and DMZ boundaries before connecting shop-floor equipment to enterprise systems. Vendor strategy matters just as much for long-term flexibility. Prioritize open standards over single-vendor lock-in so you can add capacity or switch platforms down the road.

Common Mistakes to Avoid During Integration
Most failed integrations aren't technology failures. They're sequencing and preparation failures.
- Skipping process mapping. Automating one station without mapping upstream and downstream dependencies moves the bottleneck instead of removing it—and can add complexity without improving throughput.
- Selecting equipment on price alone. The cheapest robot often creates compatibility and performance problems that only show up after installation, when fixes cost far more.
- Underinvesting in training. When operators don't fully understand the system, it runs below capability and small errors turn into downtime.
- Treating integration as a one-time project. Automation needs a roadmap for upgrades and new product lines—not an install-and-forget purchase.
Conclusion
Integrating manufacturing automation systems succeeds when it follows a structured sequence: audit, design, select, simulate, install, train. Jumping straight to a hardware purchase skips the work that actually determines whether the project pays off.
Most failed integrations trace back to skipped preparation, poor data standardization, or underinvestment in workforce readiness. Rarely is the technology itself the problem.
Workforce readiness is the half most teams underbuild. GLOBAL Automation Technologies pairs robotic systems integration with technical staffing so one partner covers both. Installing a system is only half the job; having the engineers to run it is the other. Under one roof, you get the robots and the people who keep them running.
Frequently Asked Questions
What does manufacturing automation mean?
Manufacturing automation is the use of control systems, robotics, and software to run production tasks with minimal human intervention—repeatable and consistent, shift after shift.
What is the difference between automation and integration?
Automation mechanizes individual tasks, like a robot loading a CNC machine. Integration connects those automated tasks and systems so data and equipment operate as one coordinated whole.
What are some examples of automation in manufacturing?
Common examples include robotic welding, machine tending, palletizing, and assembly; automated inspection and vision systems; dispensing and painting cells; and AGVs or AMRs for material handling.
How long does it take to integrate automation systems into an existing plant?
Single-cell integrations can take weeks to a few months. Plant-wide integration spanning MES and ERP typically takes 6 to 18-plus months, depending on legacy system complexity.
Can automation systems be integrated with legacy equipment?
Yes, through middleware, protocol converters, or targeted PLC and hardware upgrades. A compatibility assessment during the audit phase should come first.
How much does manufacturing automation integration cost?
Costs vary widely by scope, since the robot itself is often only about one-third of total installed cost. As a benchmark, machine tending cells typically pay back in 12 to 18 months.
