Introduction
Machine commissioning is the process of testing, verifying, and certifying that a newly installed or integrated machine operates safely, reliably, and to design specifications before it enters full production.
Manufacturing engineers, plant managers, and OEMs or Tier 1 suppliers feel the pressure when new robotic cells or production equipment come online.
Get commissioning wrong, and you inherit safety risk, quality escapes, and unplanned downtime that can cost $125,000 per hour, according to a 2023 ABB survey on unplanned industrial downtime.
Yet commissioning is frequently confused with "installation" or "startup," and it's poorly understood at the operational level despite being one of the costliest phases to get wrong.
This article breaks down what commissioning actually involves, the steps it follows, where it applies, and the challenges teams run into most often.
Key Takeaways
- Commissioning verifies a machine is safe, functional, and correctly integrated before it runs unattended
- Occurs after installation in the real production environment — not during Factory Acceptance Testing
- Five stages: documentation review, installation checks, integration testing, performance verification, and sign-off
- Improper mounting and integration failures cause the most downstream problems
- A single integrator owning both the build and commissioning cuts handover risk
What Is Machine Commissioning?
Machine commissioning is the structured process of inspecting, testing, and certifying a machine after it is installed. Mechanical, electrical, and control systems must perform as designed in the actual operating environment.
The goal is straightforward: a machine that's safe, running to spec, and integrated with the equipment around it, ready for reliable production with minimal operator intervention. Commissioning isn't a formality tacked onto the end of a project. It's the last checkpoint before a machine's mistakes become your production floor's problems.

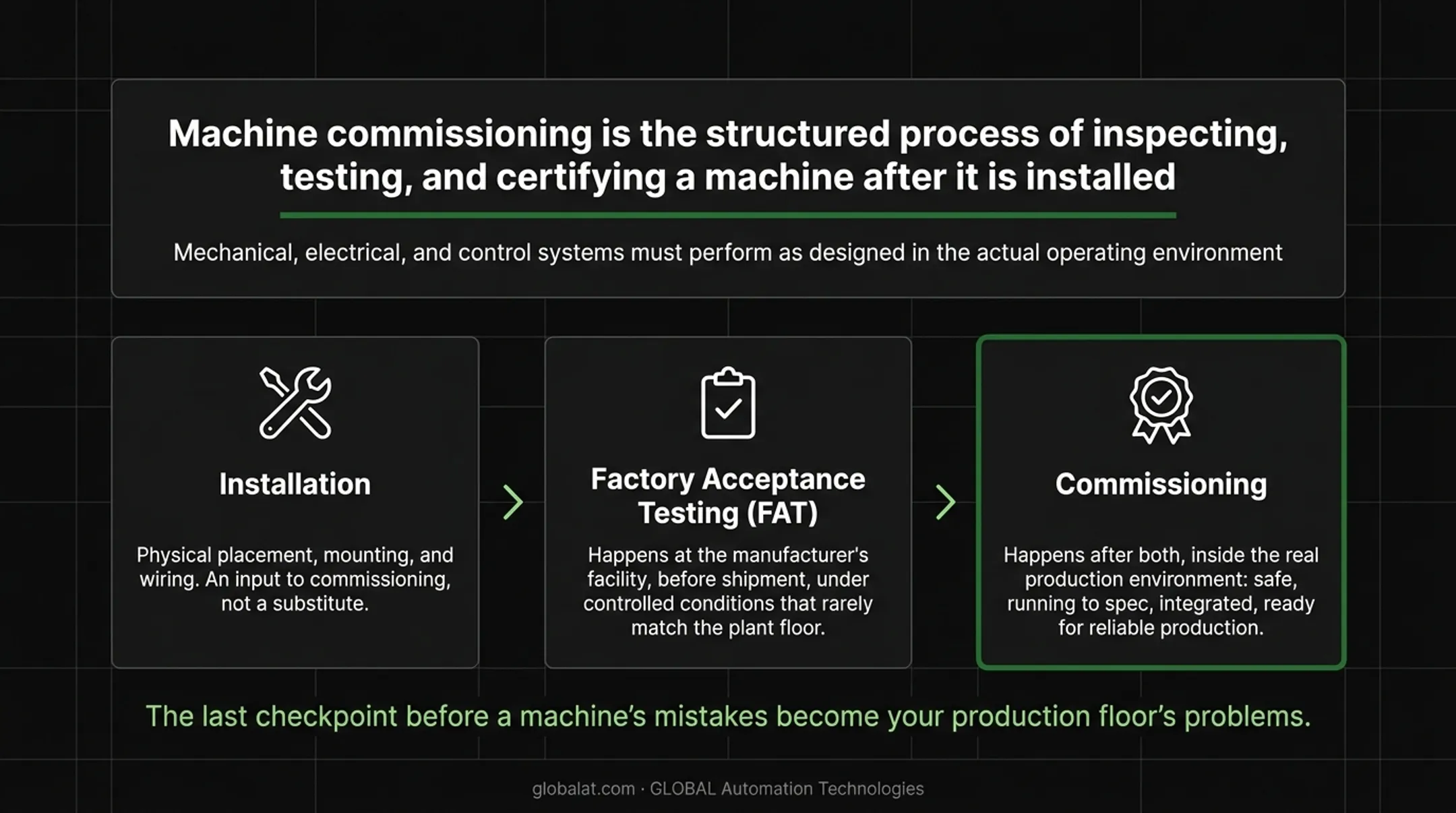

It's easy to confuse commissioning with two closely related processes:
- Installation is the physical placement, mounting, and wiring of the machine. It is an input to commissioning, not a substitute for it
- Factory Acceptance Testing (FAT) happens at the manufacturer's facility, before shipment, under controlled conditions that rarely match the plant floor
Commissioning is what happens after both of those are done, inside the real production environment.

Why Machine Commissioning Matters in Manufacturing
Manufacturers adopt formal commissioning for three reasons: safety compliance, consistent throughput, and avoiding unplanned downtime. The stakes are steep.
According to Siemens' 2024 downtime cost analysis, automotive manufacturers now lose $2.3 million per unproductive hour — more than double the 2019 figure. Even small to mid-sized manufacturers can see costs climb to $150,000 per hour.
Skip proper commissioning and you're likely to run into:
- Undetected installation errors that surface weeks into production
- Integration failures between the new machine and existing lines
- Safety incidents during first production runs, when everyone's paying the least attention to edge cases
Is commissioning legally mandated? Not exactly. Regulations like the EU Machinery Directive and OSHA's 1910.212 require documented risk assessments, guarding, and conformity work. Neither prescribes a formal process called "commissioning."
It remains an operational best practice: it helps satisfy those safety obligations while protecting uptime and the return on automation investment.
The Machine Commissioning Process: Step-by-Step
Commissioning takes an installed machine plus its design documentation as input, runs it through structured testing and controlled trials, and outputs a certified, production-ready asset.
Teams control the process with checklists, test scripts, and reference documents such as technical specifications, design drawings, and acceptance criteria. Skip a step and you lose the baseline that makes later results defensible.
Step 1: Pre-Commissioning Documentation Review
Before anyone touches a power switch, the team confirms the paperwork is complete:
- Project requirements and design documentation
- Technical drawings and control schematics
- Safety and risk assessment records
Missing documents here don't just slow the schedule. They leave later testing with nothing solid to measure against.
Step 2: Installation and Hardware Verification
The team checks cables, sensors, mounting hardware, and mechanical components against drawings and specs to confirm correct installation and a safe power-on condition. Errors caught here cost the least to fix and the most if they surface later.
Step 3: Functional and Integration Testing
Engineers cycle the machine through its functions while validating I/O, PLC logic, and connections to other machines or the line control network. A unit that ran cleanly during FAT can still behave unpredictably once it talks to live plant systems.
Integrator experience matters at this handoff. GLOBAL Automation Technologies, a top-tier Level 5 FANUC Authorized System Integrator, keeps the same controls engineers on the job from robot-to-PLC interface build through on-site validation, which cuts the ownership gaps that usually create integration surprises. The team also uses AI-assisted simulation to model robot programs and catch sequencing conflicts before the cell connects to live line controls.
Step 4: Performance Verification and Trial Runs
The team measures electrical readings, cycle times, and throughput against defined performance parameters. A trial production run (with or without live material) then confirms the machine holds up under real conditions, not only ideal ones.

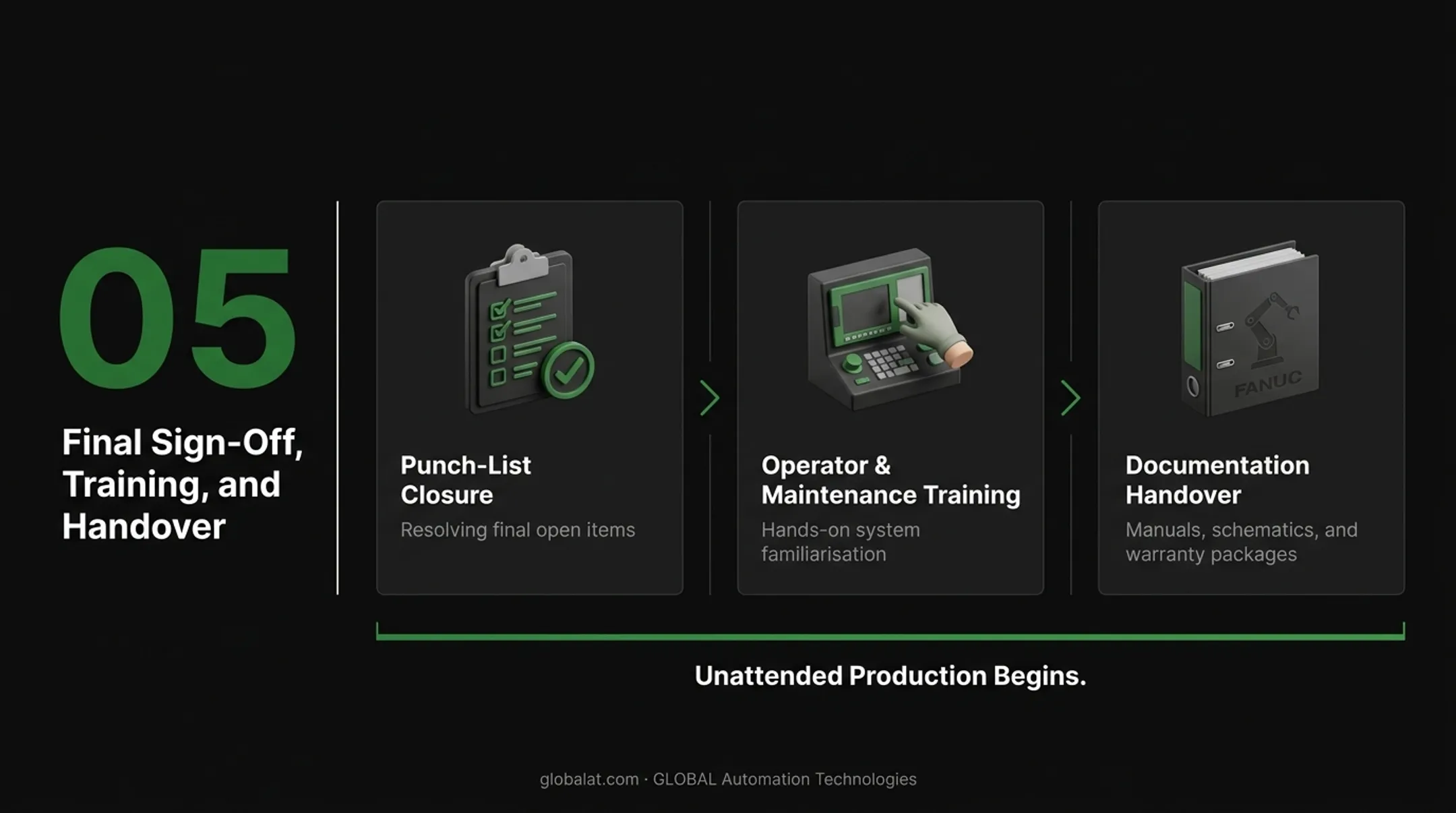

Step 5: Final Sign-Off, Training, and Handover
The team closes punch-list items, trains operators and maintenance staff, and packages documentation for handover. Only then does the machine move into regular, unattended production.

Where Machine Commissioning Is Applied
Commissioning applies to nearly any equipment that moves parts, joins materials, or interfaces with a production line. Common applications include:
- Robotic work cells (welding, assembly, machine tending)
- CNC machining and fabrication systems
- Painting, coating, and dispensing lines
- Conveyors and material handling systems
- Packaging and assembly equipment
Timing matters as much as scope. Commissioning typically happens at three lifecycle points:
- Immediately after installation
- Before production ramp-up
- After major retrofits or controls upgrades
For a given installation, commissioning is usually a one-time event. It gets repeated any time equipment is relocated, reconfigured, or significantly upgraded. A moved robotic cell needs the same scrutiny as a brand-new one, since placement and interfaces have changed even if the hardware hasn't.
Key Factors and Common Challenges in Machine Commissioning
Key Factors That Affect Commissioning Outcomes
A handful of variables determine whether commissioning goes smoothly or drags on for weeks:
- Documentation completeness — incomplete drawings or missing risk assessments slow every downstream step
- Installation and mounting accuracy — poor mounting drives vibration, noise, and shortened equipment lifespan
- Integration complexity — connecting to other machines, building management systems, or line controls adds testing time and risk
- Scale and throughput requirements — higher-volume lines demand more extensive functional and trial-run testing
Common Issues and Misconceptions

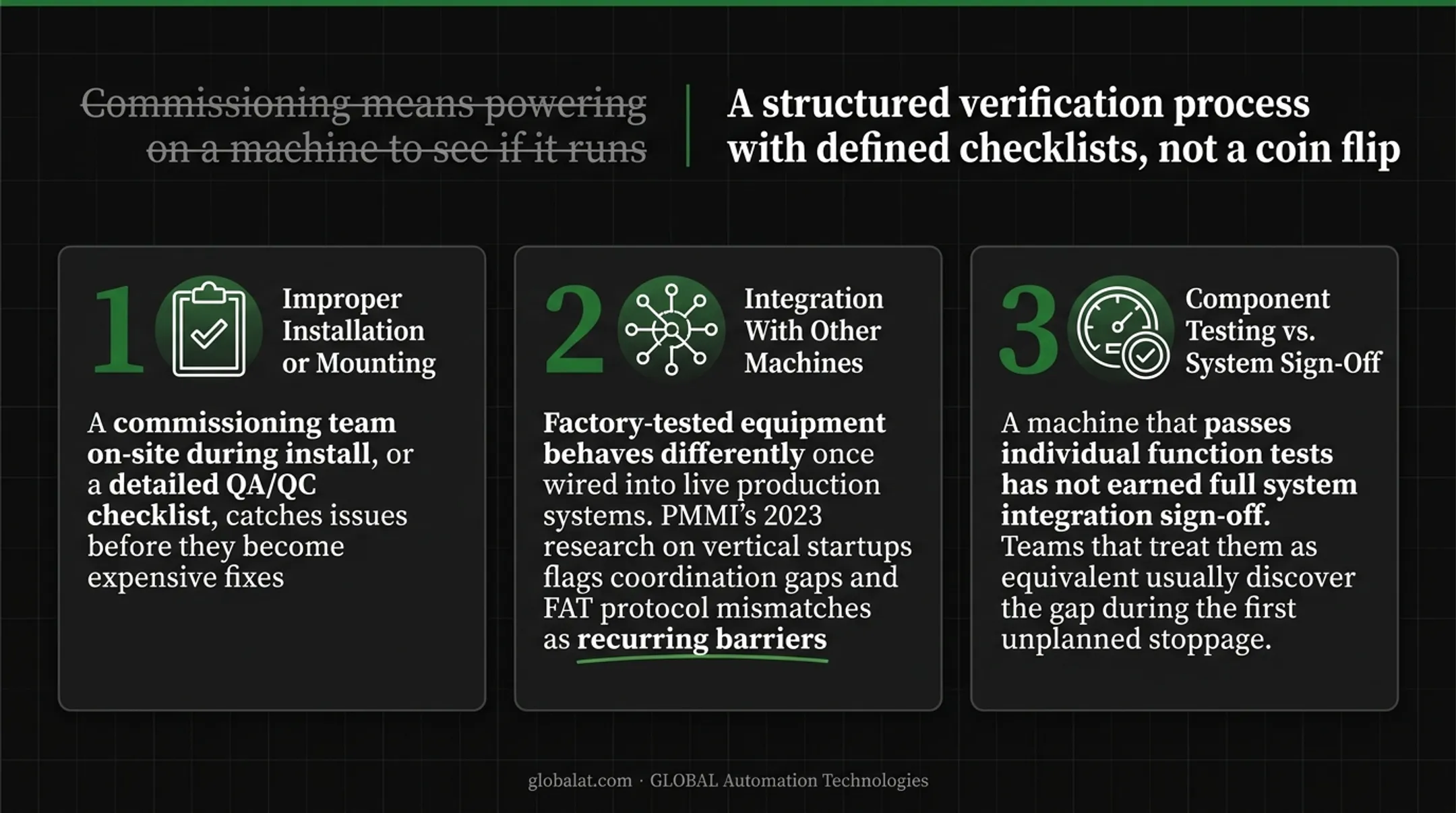

The biggest misconception? That commissioning means powering on a machine to see if it runs. It's a structured verification process with defined checklists, not a coin flip.
Here's where teams actually get tripped up:
- Improper installation or mounting is a leading source of downstream problems. A commissioning team on-site during install, or a detailed QA/QC checklist, catches issues before they become expensive fixes.
- Integration with other machines is the most common real-world challenge. Factory-tested equipment behaves differently once wired into live production systems. PMMI's 2023 research on vertical startups flags coordination gaps and FAT protocol mismatches as recurring barriers.
- Component testing and system sign-off get confused constantly. A machine that passes individual function tests has not earned full system integration sign-off. Teams that treat them as equivalent usually discover the gap during the first unplanned stoppage.

Conclusion
Machine commissioning is the structured bridge between installation and full production. It confirms a machine is safe, compliant, and performing to spec before it's trusted to run without a human watching every cycle.
Understanding this process protects three things that matter to every plant manager: uptime, safety, and the return on your automation investment.
Successful commissioning depends on experience, not checkbox compliance. Partners like GLOBAL Automation Technologies, who handle layout, build, and commissioning under one roof, reduce handover risk for OEMs and Tier 1 suppliers by keeping the same engineering team accountable from first sketch to final sign-off.
Reach out to GLOBAL's team if you're scoping a new robotic cell or line upgrade.
Frequently Asked Questions
What does it mean to commission a machine?
Commissioning means testing and certifying a machine's mechanical, electrical, and control systems to confirm it performs safely and as designed before it enters regular production. It's the final verification step, not a formality.
What is the process of machine commissioning?
The process flows through five stages: documentation review, installation verification, functional and integration testing, performance verification, and final sign-off with handover. Each stage builds on the one before it.
How long does machine commissioning take?
Duration depends heavily on machine complexity and integration scope. A standalone piece of equipment might take a day or two, while a multi-machine robotic line with heavy controls integration can take several weeks.
What's the difference between machine commissioning and Factory Acceptance Testing (FAT)?
FAT happens at the manufacturer's facility before shipment, under controlled conditions. Commissioning happens on-site after installation, in the machine's real operating environment, connected to actual line systems.
Who is responsible for machine commissioning?
A commissioning lead or systems integrator typically coordinates the effort, working alongside electrical, mechanical, and automation specialists plus the plant's own operators and maintenance staff.
What happens if a machine isn't properly commissioned?
You risk undetected installation errors, integration failures with existing systems, safety incidents during early production runs, and costly unplanned downtime once the machine is fully operational.
